Chronologie de Nomad City

L’histoire du projet Nomad City

Dernière mise à jour
5 octobre 2026
Prochaine mise à jour
October 2026
Publié par
Samana Group

Photo · 8 août 2024 La baie de Samaná et Cayo Levantado, vues depuis les hauteurs de Monte Rojo. La colline au premier plan est Nomad City.

2006
The year the land bank behind Nomad City began to be assembled.
Origin
1,083,500 m²
Land secured by the Samaná Land Bank Trust across two quarters.
Q4 2025 + Q1 2026
5
Phase 1A houses with structural works complete — Houses 4, 5, 6, 70 and 80.
As of Sep 2026
18
Further Phase 1A houses under way, from foundation stage upward.
As of 1 Jul 2026
~4 km
Primary roads under civil works, with drainage, water, power and fibre to every plot.
As of Aug 2026

2006 — 2017

Chapitre un

The land came first

Long before there was a company, there was a land bank. For fifteen years the founders bought, surveyed and registered land across the Samaná Peninsula — the patient, unglamorous work that makes everything after it possible.

2006 — 2007Origine

Titles get fixed before land gets bought

The founders settle on the peninsula and establish what becomes its largest land surveying and titling company, acting for around 1,500 clients.

This matters more than it sounds. In the Dominican Republic, the difference between a clean, deslindado title and a disputed one is the difference between a development and a lawsuit. Ten years were spent learning that distinction on other people's land before any of it was bought.

2007 — 2017Terrain

A decade of quiet assembly

Parcel by parcel, option by option, one of the largest privately held land positions on the peninsula is put together. No marketing, no investors, no website — and, at that point, no plan for what to build on it.

2017Preuve de concept

Five eco-lodges and two small condominiums

The founders open five eco-boutique hotels with local partners and build their first two small condominium buildings. They prove that low-density, design-led hospitality works commercially in Samaná — the ground the Nomad City idea would later stand on.

2021 — 2022

Chapitre deux

The idea arrives

Land without a vision is just land. In the last days of 2021 Marek Zmysłowski — a technology founder who had built and scaled companies across Africa and Europe — looked at the hills above El Valle and Monte Rojo and saw something nobody there had proposed: an entire private town, designed around health, nature and remote work, built to a single plan.

juil. — déc. 2021Origine

Monte Rojo becomes Nomad City

Marek Zmysłowski begins working on the peninsula’s two great unbuilt sites: El Valle and Monte Rojo. He had spent a career building things that did not exist yet. Now, he saw the possibility of doing it at an entirely different scale. What he needed was land — and the founders had spent fifteen years assembling it.

Monte Rojo — the red mountain — becomes Nomad City.

The first substantive request he sends, three days after the company email address exists, is not for a rendering or a brand. It is for an example of a Dominican land title. The paperwork came before the picture.

janv. 2022Conception

Architects are brought in

Berlin practice Jasper Architects begins work on the El Valle and Monte Rojo developments, and an investment agreement with the practice follows later that year. The concept is no longer a conversation; it is on paper.

mars 2022Communauté

Investors are flown in, not pitched

An eight-day programme brings the first prospective investors to the peninsula to walk the land themselves. The pattern holds for the next four years: people are asked to stand on the hillside before they are asked for anything else.

déc. 2022Capital

The seed round closes

Investment agreements are executed through the final days of December. The company enters 2023 funded, with a masterplan in progress and land under contract.

2022Entreprise

Samana Group Holding is created

Marek consolidates the land bank, the titling business and the hospitality projects into a single holding company built to develop, not just to own. Investors and advisors join. A Polish joint-stock company, Samana Nomad City S.A., is incorporated in November as the vehicle for a public share issue.

2023

Chapitre trois

From plan to ground

The year the project stopped being an idea. Land was bought before a notary, a masterplanner was appointed, permits were obtained, the funding round was closed — and on 8 November the first machine cut into the hillside.

2023 — 2024Communauté

The families who were already living there

Parts of the land had long been occupied by farming families. Dominican law is clear and firmly on the side of the registered owner, and the fast route was available. Samana Group did not take it.

“The occupants are mainly poor farmers searching for land to grow food and survive. We have agreed with each family to move them to a new house built by Samana Group on a piece of land donated to them by Samana Group.”Marek Zmysłowski · Investor Letter, H1 2024

Every family was rehoused, on land given to them, in houses the company built. It took longer and cost more than an eviction order would have. It is also the reason Nomad City is built alongside the communities around it rather than against them — and the practice has been carried forward onto every parcel acquired since.

T1 2023Terrain

The land for the whole project is secured

Land for the first stages of Nomad City is acquired outright, with the position for the entire project secured behind it — enough ground for all seven planned stages, held before a single house was sold.

avr. 2023Terrain

The first Nomad City land is signed before a notary

The first notarised transactions for the Nomad City land are executed and delivered by Dominican counsel. The ground the town would stand on is now held on clean, registered title.

Early 2023Conception

A masterplanner is appointed

An internationally recognised practice is appointed to masterplan the community, and an experienced Dominican legal counsel — previously in-house at Philip Morris Caribbean and at Grupo Puntacana — joins to run the legal side.

T3 2023Permis

First construction permits obtained

The construction permit for the showroom is granted by the municipality, along with a low environmental impact certification, and a tender opens for contractors — weighted towards firms that have already built on the Samaná Peninsula.

8 nov. 2023Pose de la première pierre

Ground is broken

Work begins on Nomad City I. The first technical roads are cut into the masterplan, ground clearing starts for the car park, the condominium and the first six villas, and power, cameras and perimeter fencing come to site.

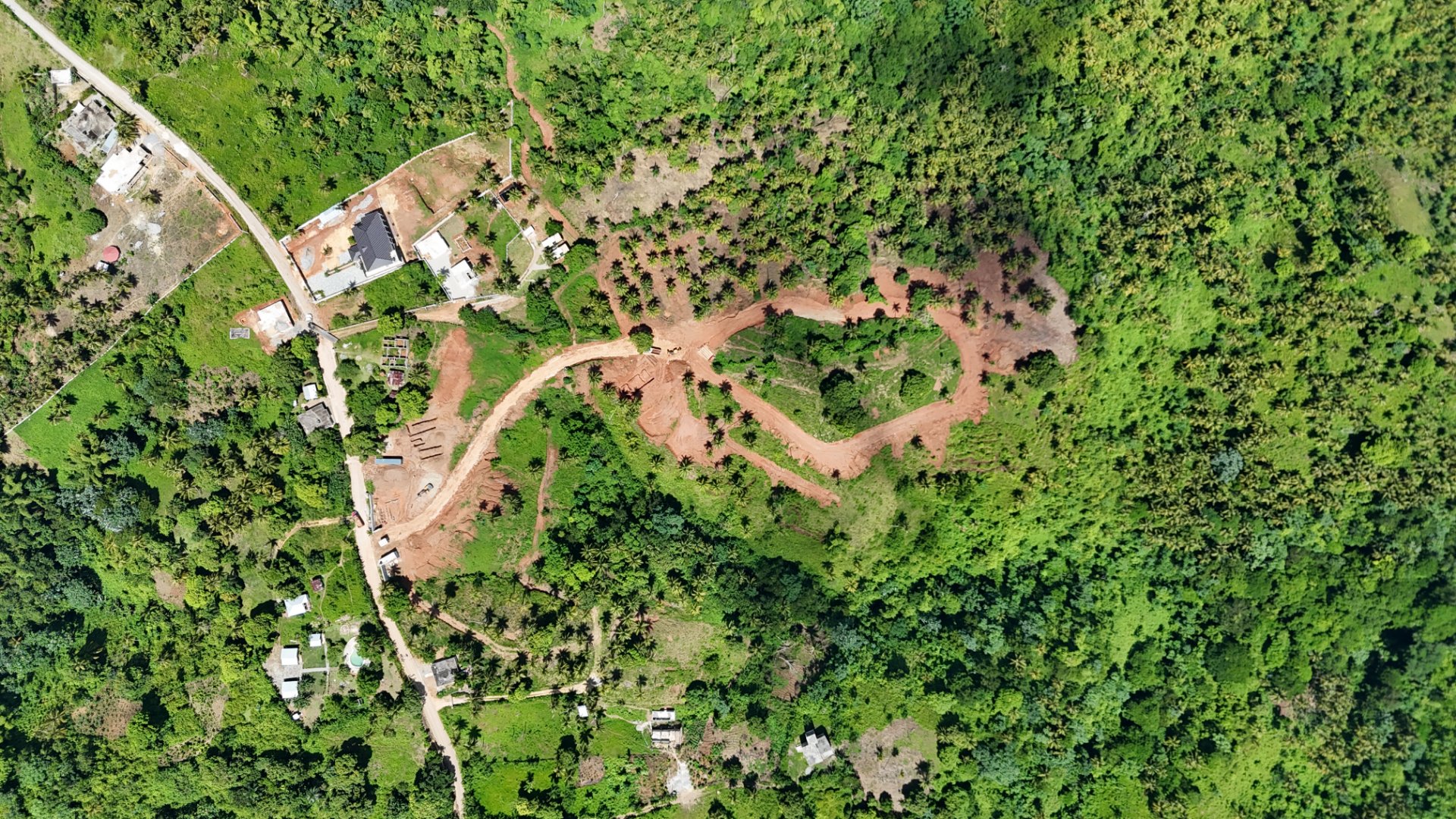

Aerial view of newly cut earth roads winding across a green hillside above the bayRegarder sur YouTube
Vidéo · 13 nov. 2023The groundbreaking ceremony at Nomad City. Also on Instagram.

21 nov. 2023Conception

The architecture is credited

With construction underway, the concept's authors are named: Pit Marenco and Traktor Arquitectura, the practice behind the Nomad City design language.

1 déc. 2023Construction

The road comes before the foundations

On a mountain, the basics are not footings — they are access. The first phase of the approach road is completed: staking, excavation, ground compaction and sub-base. Geotechnical investigation finishes alongside it, giving the engineers exactly what they need to design foundations and drainage for the slope.

Building platforms and cut roads among palms on the Nomad City hillsideRegarder sur Instagram
Vidéo · 1 déc. 2023The first road phase complete, and the geotechnical investigation that came with it.

2023Capital

A regulated public share issue

Offering documents are filed with Poland's financial supervision authority and a regulated equity issue goes to market. Series B shares are allotted to the new shareholders in August and entered in the shareholders' register kept by Trigon Dom Maklerski before the year is out.

2024

Chapitre quatre

The first houses

Thirty platforms cut into the hillside, foundations poured, the first walls standing, a showroom open and a house type designed to be built the same way a hundred times. The year Nomad City became something you could walk through.

17 janv. 2024Construction

The roads are 3D-scanned across the whole masterplan

The road network cut across the entire Nomad City masterplan is captured in 3D scans — a permanent, measurable record of what is actually on the ground. Excavation begins for the condominium foundations and geotechnical testing extends across the remaining plots.

Photo · avr. 2024The masterplan road network, cut and graded, seen from the air.

févr. 2024Produit

The Flat House

A configurable, repeatable house type launches — designed to be built the same way a hundred times rather than bespoke once. Marek's framing to investors at the time: "Our Flat House is our Ford Model T. To paraphrase the famous quote: you can get it in any variation you want, as long as it's in the configurator."

RenduThe Flat House as designed — a single-storey villa with a planted roof, set into the slope.

avr. — juin 2024Construction

Excavation, footings, and the first columns

Groundwork begins for the condominium and the first three Flat Houses, with twenty more behind them. Thirty platforms are excavated into the hillside. Footings are laid out, rebar is tied and the first columns go up.

Excavator working in red earth among palms, captioned Nomad City ProgressRegarder sur YouTube
Vidéo · 13 juin 2024Construction vlog — roads, excavations and foundations for the first condominium and five villas. Also on Instagram.
Photo · 29 mai 2024Cutting the first terraces into the slope, between the palms rather than through them.
Photo · 14 juin 2024The internal road cut through the palm grove, seen from above.
Photo · 15 juin 2024First columns cast on a prepared platform, Nomad City 1A.

11 juin 2024Ingénierie

The ground gets explained on camera

A geotechnical engineer is put in front of a camera to talk about what the hillside is actually made of — clay depth, rock formations, slope stability, and what it takes to build on it so the houses are still there in a hundred years. Most developers show the view. This series showed the soil.

An excavator beside a freshly cast reinforced concrete column on a building platformRegarder sur YouTube
Vidéo · 11 juin 2024Expert Series — building safely on rock, clay and slope in the tropics.

juil. — août 2024Construction

Foundations poured, first walls standing

Se colocan los cimientos en las primeras parcelas y, a continuación, se levantan los muros. Según el informe de otoño, se han retirado del terreno 13.000 m³ de tierra y se han traído 650 m³ de roca; la roca excavada se reutiliza en el lugar como material de relleno en vez de transportarse fuera. Ya se ha contratado a un contratista general y está prevista la instalación de una planta de hormigón en el propio terreno.

Photo · 26 juil. 2024The first structural walls at Nomad City 1A, beside a freshly cut technical road.
Photo · 29 juil. 2024A foundation pour from directly overhead — the pump, the crew and the slab taking shape in a single frame.
Photo · juil. 2024Platform terracing across the eastern slope, with the forest left standing between plots.
Photo · 29 juil. 2024Footings and formwork for a single Flat House. Each platform is cut and levelled individually into the slope.
Photo · 12 août 2024Reinforcement cages set and tied, ready for the pour.
Photo · 8 août 2024Plots marked out between existing palms. The masterplan holds 68% of the site as greenery.
Photo · 29 juil. 2024Gabion cells stepped into the slope — slope stabilisation before anything is built above it.
Photo · 7 août 2024Formwork and reinforcement set out across a full house footprint.

23 août 2024Communauté

The showroom opens and the first Open House is held

The Nomad City showroom opens — the interiors, materials and finishes of the villas built at full scale, so that buyers can stand in the rooms rather than read about them. Coralina stone quarried on the peninsula, local hardwood, poured concrete floors, linen, rattan: a material palette drawn from the island rather than imported onto it.

On 23 August, around 100 RE/MAX agents are hosted on site, touring the showroom and walking the foundations of the first Flat House villas. It is the first time the project is shown to a room of people with no stake in liking it.

Aerial view of the Nomad City site during the Open House periodRegarder sur YouTube
Vidéo · 27 août 2024The first Nomad City Open House, with RE/MAX. Also on Instagram.
Photo · août 2024The living space, with the bedroom beyond. Woven pendants, linen, poured concrete underfoot.
Photo · août 2024Coralina stone behind the bed — the same stone the peninsula is made of.
Photo · août 2024Hardwood table and timber screen, with the garden left visible through the room.
Photo · août 2024Carved stone basins on a hardwood vanity.
Photo · août 2024The soaking tub, cast in place and set on river stone.
Photo · août 2024Stone, timber and daylight — the finish level buyers are choosing from.

sept. — nov. 2024PermisConstruction

Earthworks permits obtained from the regional environmental office

A "no objection" is issued for the first three Flat Houses in September, and the Ayuntamiento de Samaná issues its construction permit on 7 November. On site, walls rise on three houses while foundations are dug for six more, electrical and water installations go in, and the engineered retaining walls that hold the eastern plots are built.

In the same period the company reaches its first month of operating profitability.

Photo · 17 sept. 2024Three Flat Houses under construction, seen from directly above.
Photo · 17 sept. 2024The whole site from the air — the road loop in, the plots opened, the forest still holding the rest.
Photo · 2 oct. 2024Engineered retaining wall under construction on the eastern slope.

sept. 2024Produit

The Flat House configurator goes live

Buyers can specify their own house online — layout, finishes, packages — and receive a personalised offer automatically. It is the mechanism that makes a repeatable house type feel like a bespoke one, and it turns configuration into something a buyer does themselves rather than something they negotiate.

Photo · Nomad City 1AThe configured house, built: full-height glazing, single storey, set on its own platform.

2025

Chapitre cinq

Slabs, permits, and the structure behind the build

Concrete went down on the hillside while, off it, the architecture that carries the whole project was put in place: the environmental permit, a regulated land trust with an external trustee, and a published construction schedule for every buyer. Engineers with expertise in Dominican laws and regulations were also brought on board to design the structures in accordance with the guidelines established by the relevant government ministries.

23 janv. 2025Construction

Slabs go down

Foundation slabs are poured for the first Flat Houses, with concrete tested on site and specimens collected for strength testing. Fourteen people on the pour.

Photo · 23 janv. 2025Concrete placement on a Flat House slab, Nomad City 1A.

févr. — mars 2025Construction

Nine houses under construction — and a soil study for every one

Nine of the Phase 1 houses are under construction, six of them started in a single month. Half of Stage 1 is sold.

Each plot gets its own geotechnical study before anything is poured on it. A rig is walked onto the platform, boreholes are drilled, samples are taken and the foundation is designed for that specific ground rather than for an average of the hillside. At Monte Rojo the clay depth varies between one and ten metres across a few hundred metres, which is exactly why this is done plot by plot.

Photo · avr. 2025Geotechnical drilling for plot N80 — boreholes and samples before the foundation is designed.
Photo · 28 févr. 2025Crew on the ridge at Nomad City 1A.

mai 2025Construction

Pouring through the season

Slab and structural pours continue across the site, with the concrete pump working plot to plot along the ridge.

Photo · mai 2025A full-crew pour on the upper terrace.

T2 2025Ventes

Phase 1 sells out — and sales are paused

Nomad City Phase 1 is fully sold. Rather than open Phase 2 immediately, sales are paused until Phase 1 is delivered. Selling faster than you build is how developments get into trouble here; the decision was to stop and build.

9 juil. 2025Construction

Flat House construction advances

Flat Houses rising on foundations built to last — and a site visit that month from investors and future residents, walking the plots they had bought.

Concrete pump boom over a Nomad City plot with a working crewRegarder sur Instagram
Vidéo · 9 juil. 2025Flat Houses rising. Investors on site two days later — Instagram, 11 Jul 2025.

22 · 23 juil. 2025PermisStructure

Project classification and environmental studies begin

The project is classified by the Ministry of Environment and Natural Resources, marking the start of the environmental impact studies required for Nomad City.

The following day the irrevocable Dominican trust Fideicomiso Samaná Land Bank is registered — a regulated vehicle that holds the land and infrastructure separately from the construction company, with an external trustee, Fiducapital, administering every payment and reporting quarterly. It is the single most important structural decision of the year: the land that secures the project is now held where it cannot be touched by anything else.

sept. — oct. 2025Calendrier

A construction schedule is published for every buyer

A full unit-by-unit construction schedule for Nomad City 1A is issued to buyers in English and Polish, with foundations complete on the first three houses and a dated shell-core stage set for each unit in the phase. Every owner knows where their own house sits in the programme.

In the same month an Investors' Committee is established, chaired by Piotr Baran — chief executive and co-owner of the Polish developer PCG S.A. and a board member of the Polish Association of Real Estate Developers — bringing thirty years of development governance to the table.

2026

Chapitre six

Building at full scale

Specialist contractors, a builder who finances the houses and is paid on delivery, four kilometres of road with services to every plot, and the first homes finished inside. This is the year Nomad City started to look like a town.

janv. 2026Construction

Specialists take over, trade by trade

The build is restructured around specialists rather than a single general contractor: PolBud SRL on structural work, Soluciones Modulares SRL on finishing, and R-Sosa Constructora on roads, infrastructure and houses. Each firm does what it is best at, and the programme stops depending on any one of them.

Holding that together takes a room. Contractors, engineers, architects and the Samana Group team sit around the same table on site every week, with the masterplan on the screen and the week's work in front of them.

Photo · 2026Planning session with the masterplan on screen and the bay through the windows.
Photo · 2026Contractors, engineers and the project team in the weekly coordination meeting.

févr. — mai 2026Validation

An independent feasibility study, and it agreed with us

The Nomad City feasibility study is finalised in February. Alongside it, an independent Commercial Feasibility and Financial Pre-Feasibility Study of the wider Costa Samaná landholding is commissioned from Analixis Global — a specialist brand of Castillo Zavala Construction & Investments, whose clients are the developers, banks and funds of the Dominican market. It is built on field research carried out between January and May 2026 and a review of 35 comparable projects.

It rated market attractiveness High, with an overall evaluation of favorable, with conditions — and, more usefully, it independently arrived at the strategy the project had already chosen: low-density eco-luxury and wellness positioning, villas and boutique apartments with hospitality-grade operations, phased and self-sufficient execution, and European and North American second-home, lifestyle and eco-wellness buyers as the core market.

The conditions it attaches are the institutional steps still in progress — MITUR parameters, environmental permitting for the wider landholding, and CONFOTUR classification — before the masterplan is finalised or sales open at scale.

Étude · 2026The study's own technical fact sheet — scope, land area, unit mix, stages and target markets. From the H1 2026 investor report.

23 févr. 2026Construction

Phase 1A slabs poured; Phase 1B begins

Advanced structural works run across Phase 1A — main floor slabs poured, foundation bases completed, engineered plot platforms prepared. In Phase 1B, earthworks start: road profiling and the first underground utility routes.

Photo · févr. 2026House 5 going up: walls cast, props and formwork in place for the roof slab, the cut bank behind it already reinforced.
Nomad City construction progress cover showing a concrete pump on siteRegarder sur YouTube
Vidéo · 23 févr. 2026Construction update — slabs, foundation bases and plot platforms. Also on Instagram.

18 mars 2026Permis

Construction permit certified in the Trust’s name

The municipality certifies the construction permit for the project in the name of the Trust. It enters the CONFOTUR application dossier, joining the municipal construction permit of November 2024 and the environmental permit of July 2025. Guzmán Ariza — one of the country's leading firms — takes the Nomad City masterplan permitting mandate in September.

T1 2026Terrain

876,500 m² secured, including the first beachfront

The Trust brings roughly 876,500 m² under control in a single quarter, including its first beachfront parcel. Around 43% of capital deployment goes to land acquisition and 38% to land development and infrastructure — money going into the ground, not into overhead.

mai 2026Construction

The builder finances the houses

An integrated execution partnership is signed with a consortium led by R-Sosa Constructora, alongside Soluciones Modulares and Ricardo Cruz & Associates. Fifty residential units are delivered and paid for on delivery rather than in advance — the contractor carries the construction financing — with insurance behind the structure. Management believes no other developer in the Dominican Republic has put comparable terms in place.

R-Sosa built the main road from Samaná town up to Monte Rojo. The same team now delivers Nomad City's own four kilometres of primary roads — stormwater drainage, potable water, electrical service, public lighting and fibre to every plot — and builds houses alongside Soluciones Modulares.

A fortnight later R-Sosa posted their own film about the project, on their own channel — "nos enorgullece ser la empresa responsable de desarrollar toda la infraestructura": proud to be the company responsible for developing the entire infrastructure. A contractor putting their name to a project on their own account, unprompted, is worth more than any line we could write about them.

A new road cut through Nomad City with houses under construction beyondRegarder sur Instagram
Vidéo · 13 juil. 2026Meet the team that built the road to Monte Rojo — now building ours.
A newly surfaced road with kerbs climbing the hillside at Nomad CityRegarder sur Instagram
Vidéo · 25 juil. 2026Posted by R-Sosa Constructora on their own channel, about Nomad City.
An R-Sosa roller compacting the crushed-stone layer of a new Nomad City roadRegarder sur Instagram

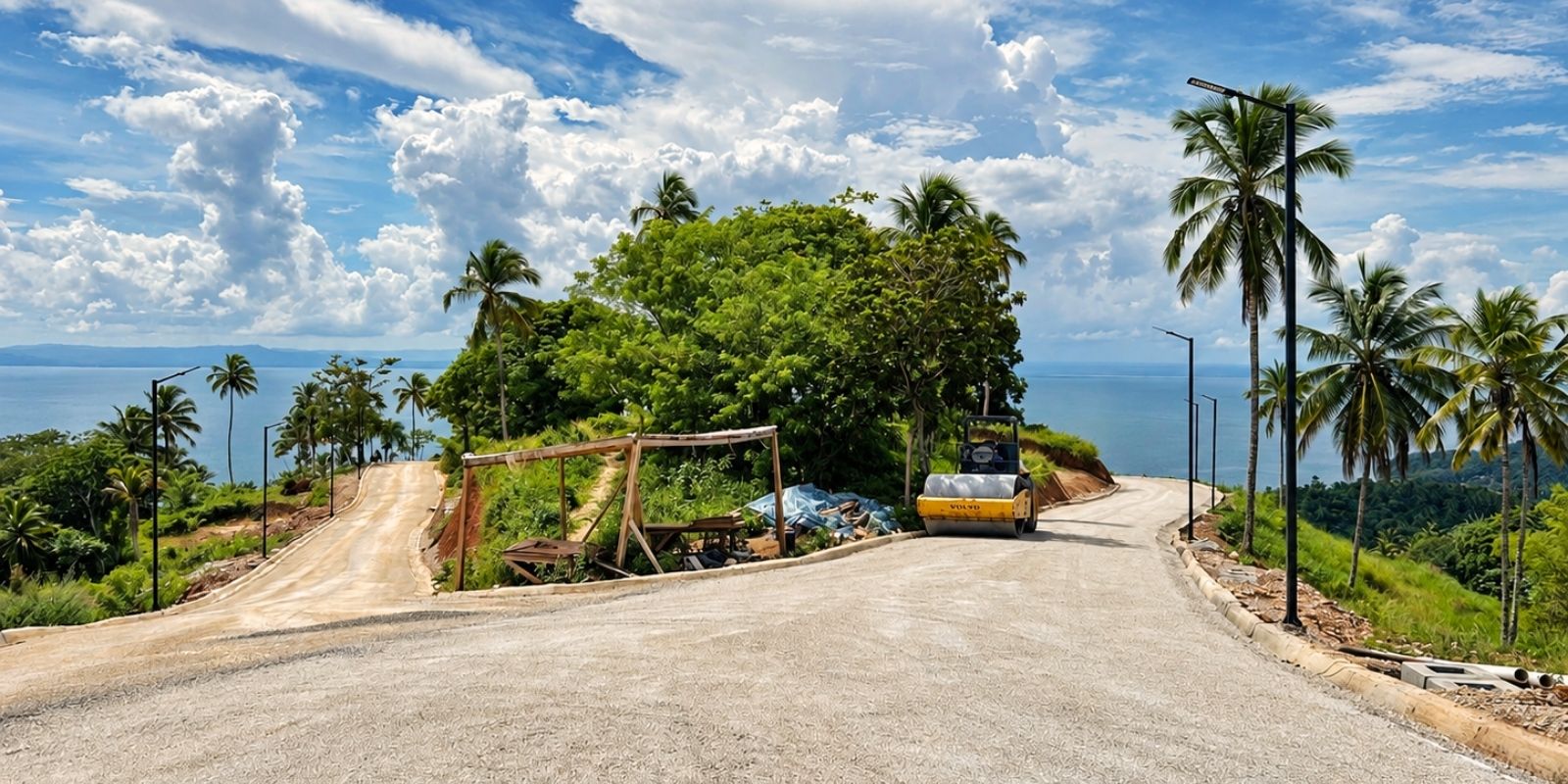

Vidéo · 29 juil. 2026R-Sosa on delivering every contract to the highest standards of quality, engineering, planning and safety — building infrastructure meant to last, and to add lasting value at every stage.
Photo · mai 2026Heavy plant arrives on the ridge to cut and grade the primary roads.

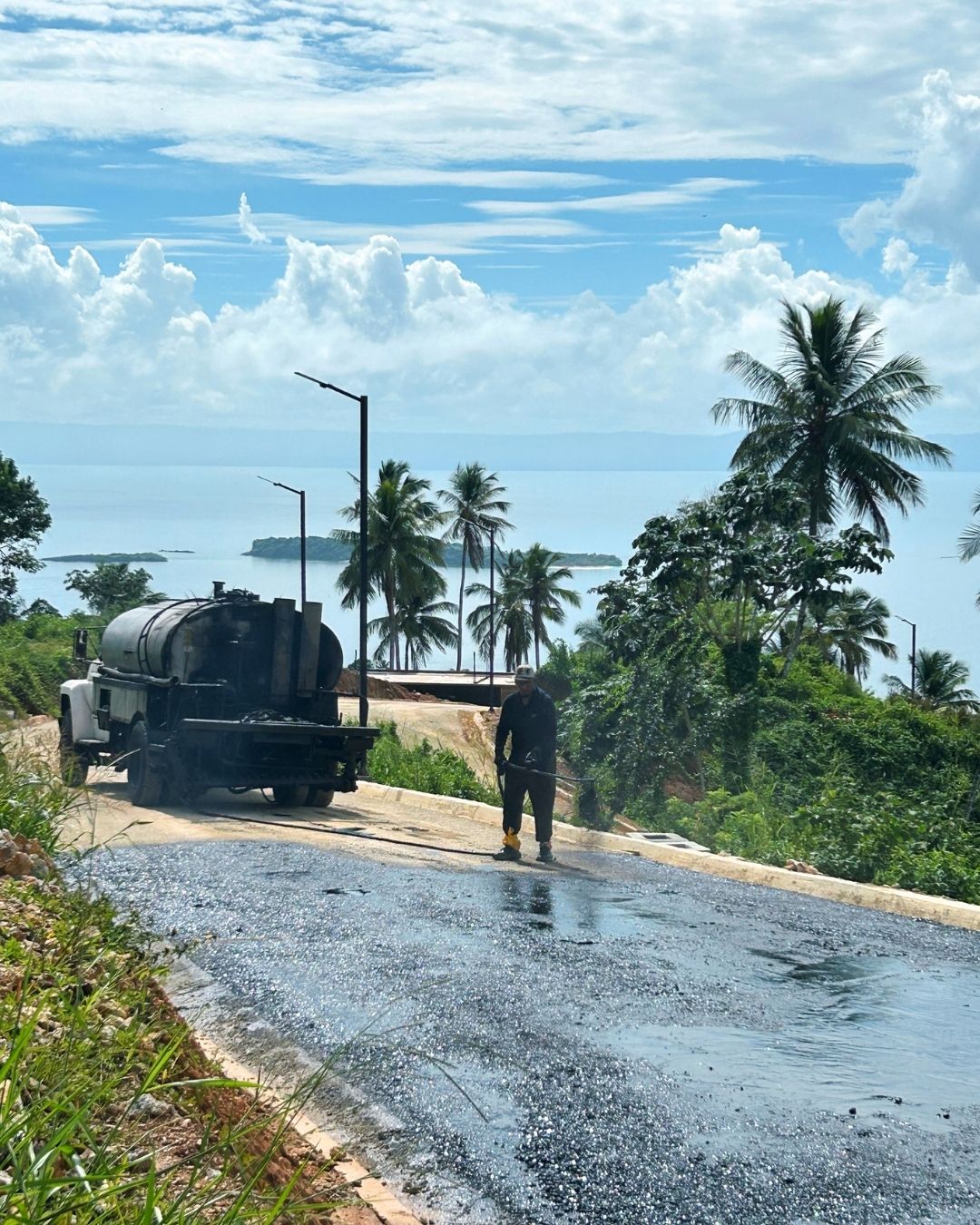

Photo · mai 2026Fill hauled and tipped where the road climbs through the palms.

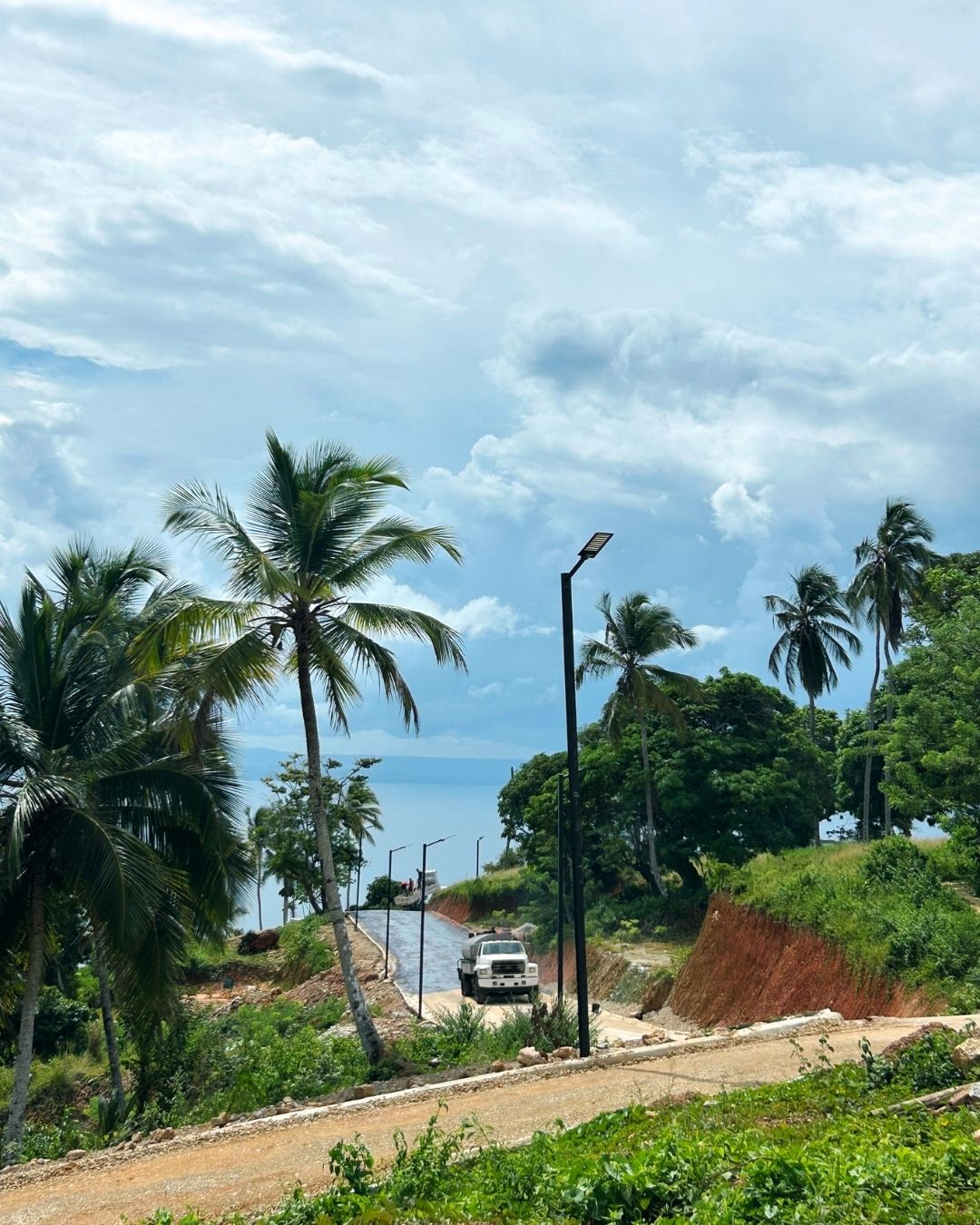

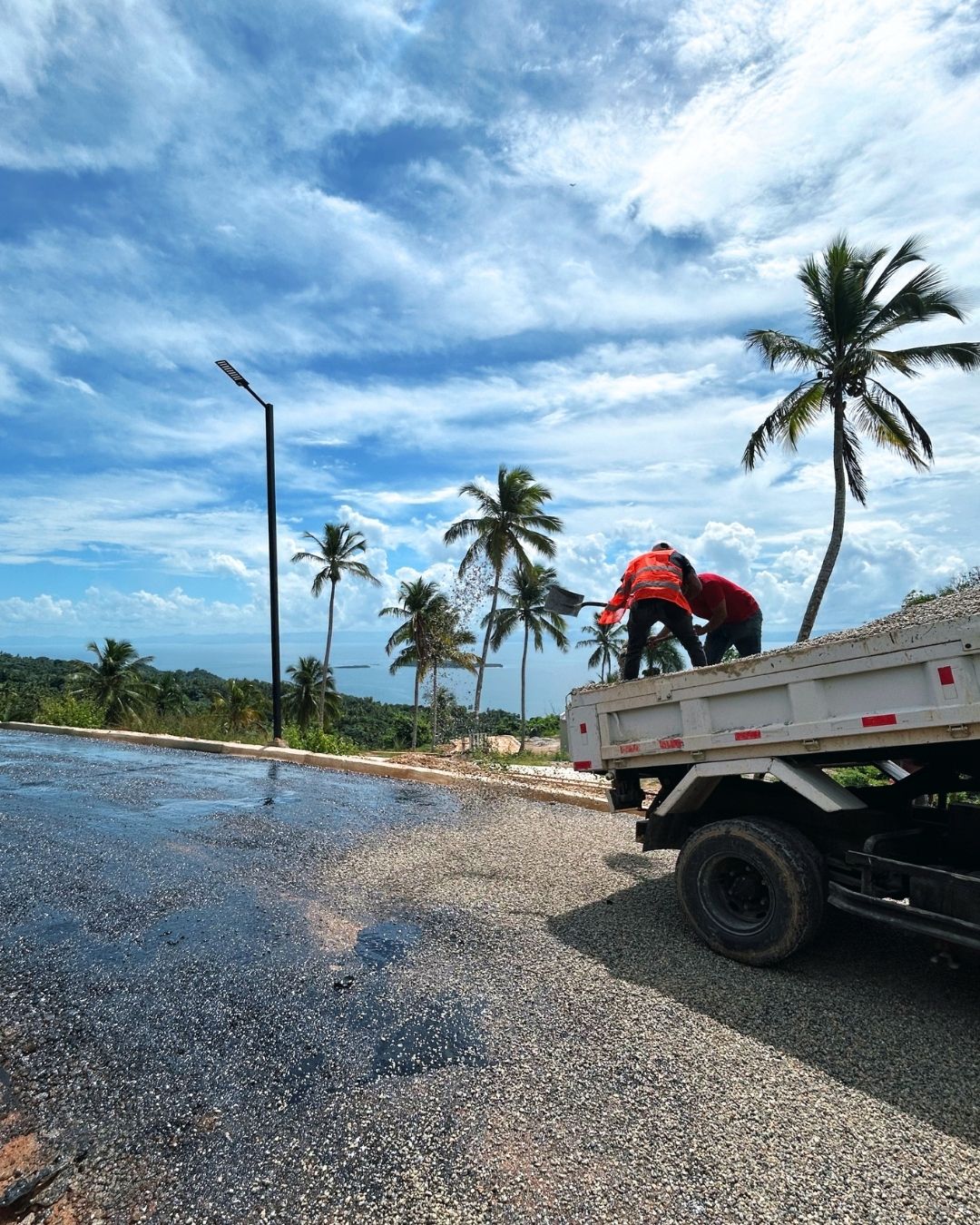

Photo · mai 2026R-Sosa's roller compacting the sub-base — the layer everything else depends on.

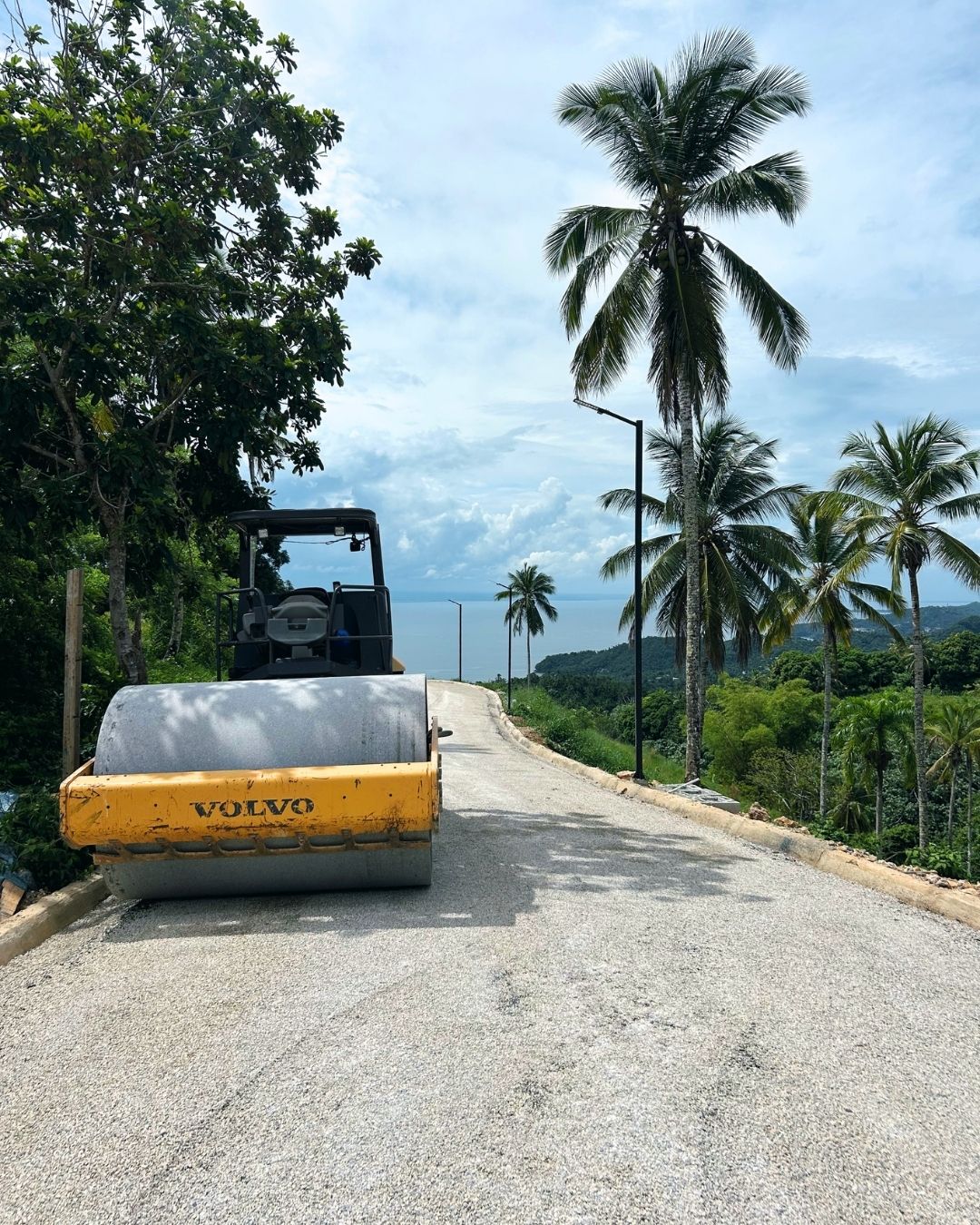

Photo · mai 2026Working the crushed-stone layer on the ridge, the bay just beyond the treeline.
Photo · mai 2026Roller and compactor on the climb, the road threading between the palms rather than through them.
Photo · mai 2026The drum on the finished stone layer, the road already at full width.

juin — août 2026Construction

The lights come on — and they run on the sun

The public lighting grid is installed and operational across Nomad City 1A, on solar streetlights along the main roads. Main interior works are completed on the first reference home, several houses reach advanced enclosed structural stage, and plot preparation extends into Nomad City 1B.

Photo · 7 août 2026Street lighting live on the Nomad City 1A road. Three years earlier this was forest.
Photo · 5 août 2026A finished Flat House on its plot. Two years earlier this was a platform cut into the slope.
A newly built road at night lit by installed solar street lightsRegarder sur YouTube
Vidéo · 21 août 2026Solar streetlights across the main roads of Nomad City.
Photo · 4 août 2026Kerbs in, surface down — the road that serves the upper terrace.
Photo · 5 août 2026One of the solar streetlights, with the bay behind it.
Photo · 31 juil. 2026The reference home with glazing installed and interior lighting connected.
Photo · 6 août 2026Living room of the reference home, glazing in, finishing underway.
Photo · 4 août 2026Bathroom, stone cladding laid, fixtures being set.
Photo · 5 août 2026A bedroom taking its finishes.

1 juil. 2026Construction

Houses 4, 5 and 6 top out

Structural works are complete on the first three Phase 1A houses. Eighteen further houses are at foundation stage, Phase 1B foundation work is underway, and the first panoramic window frames go in.

Photo · 31 juil. 2026Nomad City 1A from the access road, structures at varying stages along the slope.
Hillside with new roadworks and the bay beyondRegarder sur YouTube
Vidéo · 17 juil. 2026Full-scale works underway — kilometres of new roads and the first Flat Houses rising. Also on Instagram.
Photo · juil. 2026Two houses on adjacent terraces — the lower one glazed and roofed, the one above it at open-shell stage.
Photo · juil. 2026Glazing installed, seen from the terrace below. The palms on the plots were kept where they stood.
Photo · 30 juil. 2026Crane lifting structural elements into place on the upper terrace.
Photo · 6 août 2026Concrete on the NC1A internal road. Roads are built before the houses that use them.
Photo · 30 juil. 2026A module set onto its platform.

6 juil. 2026Environnement

An independent environmental study, and a wetland turned into a reserve

Pro-Ambiente J&M, S.A. delivers an independent environmental pre-feasibility study covering geology, ecology and hydrology, and rates 60–65% of the initial area suitable for immediate development.

Its most interesting finding concerns the Bahía Carenero wetland, which it rates unsuitable for building. Rather than write the land off, the plan changed around it: acquire it at a materially reduced price, keep it permanently as a protected ecological reserve, and move the commercial area onto higher, more stable ground the study itself recommends. A constraint became an amenity few developments in the region can offer.

Étude · 6 juil. 2026Geology and characterisation of the project area. The relief model shows how much of the FOCUS area sits on gentle slope — 47.6% under 15% gradient.
Étude · 6 juil. 2026Zoning and treatment: preferred suitability, special treatment, conditional and absolute exclusion zones. The red area at the centre is the Bahía Carenero wetland — excluded from building and kept as reserve.
Photo · déc. 2024The same ground from the air: forested slope, coastal edge and the low ground below.

8 juil. 2026Infrastructure

A private road down to the beach

Nomad City gets its own route to the sea: roughly 1.3 km, a seven-minute buggy ride from the ridge down to the beach club. Buggy-passable today, street-quality by the end of the year. It looks like very little on video and represents a year of work, negotiation and permitting.

A newly formed road descending through tropical vegetationRegarder sur Instagram
Vidéo · 8 juil. 2026The seven-minute ride from Nomad City down to the beach.

24 juil. 2026Infrastructure

Drainage infrastructure for heavy rainfall

A concrete drainage channel, carrying water safely away from the road every time tropical rain hits. It will never appear on a postcard from Samaná. On a mountain site it is the difference between a road that lasts decades and a road that washes out in the first serious storm.

Workers positioning a large concrete drainage pipe in an excavated trenchRegarder sur Instagram
Vidéo · 24 juil. 2026Not Instagrammable. Very rain-manageable.
Photo · juil. 2026A truckload of concrete pipe arriving for the drainage runs.
Photo · juil. 2026Setting a section by excavator, the crew guiding it into line.
Photo · 7 août 2026Pipe bedded into the trench. This is the work that makes everything above it last.

4 août 2026Produit

How an Optional Modular Flat House is made

The modular build comes into its own: advanced prefabrication, premium materials and factory quality control mean a complete home can be ready in about nine weeks once its platform and services are in.

Prefabrication is an option, not a rule. Buyers who want the speed and the factory tolerances choose it; those who prefer conventional cast-in-place construction get that instead, to the same specification and on the same plots. Both are built by the same consortium.

A modular house module arriving on a flatbed truck at the Nomad City siteRegarder sur YouTube
Vidéo · 4 août 2026Inside the modular build with Solución Modular — prefabrication, materials and factory quality control.
A house module suspended from a crane above the Nomad City siteRegarder sur Instagram
Vidéo · 6 août 2026See how a Flat House comes to life — a complete home ready in about nine weeks.
Photo · 30 juil. 2026Solución Modular setting a module down. The house arrives largely built; the site work is what takes the time.
Photo · août 2026A wall panel set into position under the plant crane.
Photo · août 2026Module assembly on the plant floor — walls squared and joined before anything leaves the building.
Photo · août 2026Finished panels in stock, stacked upright and ready to ship.
Photo · août 2026A long-span frame under fabrication, tube stock cut to length beside it.
Photo · août 2026Board stock — gypsum, cement board and exterior sheathing, held in the plant rather than on site.
Photo · août 2026Natural stone slabs and tile in plant storage, staged for specific units.

août 2026Construction

House 70 reaches shell core

N70 stands complete at shell core: roof on, full-height glazing and sliding doors installed, stone plinth laid, floors down, internal doors hung and the terrace poured. It is the clearest picture yet of what a Flat House is — a long, low volume that opens along its whole seaward side to Samana Bay.

Photo · août 2026House 70 from the approach. Roof, glazing and stone plinth complete.
Photo · août 2026The terrace runs the full length of the house, looking out over the bay.
Photo · août 2026The living space, floors laid and glazing in.
Photo · août 2026Open sea from inside the house.
Photo · août 2026A bedroom, doors hung and glazing installed.
Photo · août 2026The second bedroom, with its own way out to the terrace.

22 sept. 2026Ventes

The first house goes on the market nearly finished

N06 is offered as a nearly ready Flat House in Nomad City I — a 956 m² plot, two bedrooms, more than 50 m² of terrace. The first unit offered on the basis of what has been built rather than what is planned.

By this point five Phase 1A houses stand structurally complete — N04, N05 and N06 on the first terrace, joined by N70 and N80 — with the rest of the fifty-unit programme moving up behind them.

23 sept. 2026FinancementLes plus récents

A Dominican bank will now finance our buyers

Samana Group and Banco BDI have entered a partnership to offer mortgage financing to Nomad City buyers — including foreign buyers, which is the part that rarely exists in this market.

The facility covers up to 70% of the property value, in US dollars, with funds released progressively against construction milestones rather than in a single drawdown, at indicative rates quoted by the bank in the 8–10% range. Every application is assessed and approved by BDI on its own terms.

For a buyer it changes the arithmetic of owning here: a Flat House stops being an all-cash purchase and becomes a financed one, on the same basis a home is bought anywhere else. For the project it is something else again — a Dominican bank underwriting lending against these houses, on this land, is an institution putting its own balance sheet behind the title work, the permits and the build quality.

sept. 2026Construction

Foundations go in for the next row of houses

Work moves along the terrace to the houses in the 60–80 range. Slabs are poured on block plinths cut into the slope, each with its service pit formed and drainage run before the concrete goes down — the same sequence that carried the first houses to shell core. Street lighting and the finished houses behind them are already in place.

Photo · sept. 2026A poured slab on its terrace, with a completed Flat House on the plot behind and the bay beyond.
A newly poured house slab on a hillside terrace at Nomad City with the bay beyondRegarder sur Instagram
Vidéo · 16 sept. 2026R-Sosa again, on their own channel: proud to be part of sustainable projects with a future. "Cada metro construido, cada avance y cada obra terminada hablan por nosotros" — every metre built, every advance and every finished work speaks for us.
Photo · sept. 2026Slab poured, service pit formed, ready for the structure.
Photo · sept. 2026The block plinth that levels the slab across the slope. Street lighting already runs past it.
Photo · sept. 2026Another slab down, palms left standing around it.

Parties indépendantes

Qui contrôle les travaux

Des cabinets nommément désignés, des missions datées, des conclusions communiquées au fur et à mesure.

  • Fiducapital S.A.

    Trustee · since Jul 2025

    External trustee of the Samaná Land Bank Trust and the Costa Samaná trust, Santo Domingo. Administers every payment and issues quarterly trustee reporting at bank-account and line-item level, plan against execution.

  • Pro-Ambiente J&M, S.A.

    Environmental · 6 Jul 2026

    Independent environmental feasibility study for Costa Samaná — geology, ecology, hydrology. 60–65% of the initial area rated suitable for immediate development, with the Bahía Carenero wetland set aside as a protected reserve.

  • Analixis Global

    Commercial feasibility · Jan–May 2026

    Field research across 35 comparable projects. Market attractiveness rated "High", and the study independently recommended the same low-density eco-luxury and wellness positioning the project had already adopted.

  • Tasaciones Exactas SRL

    Valuation · 2026

    Certified appraisers (CODIA / CATA-CODIA). Independent appraisal of the contributed Monte Rojo parcels at US$2,057,799.04, approximately US$27/m².

  • Dr Ludwik Sobolewski

    Governance · 3 Jun 2026

    Independent expert report on governance, business judgement and risk management, assessed against the G20/OECD Principles of Corporate Governance, ISO 31000, the IFC methodology and IVS/RICS valuation standards. Conclusion: management's actions reasonable, prudent and consistent with international standards.

  • Guzmán Ariza · Aliat Law

    Dominican counsel · since 2023

    Land titles, parcel purchases and construction contracts from 2023 onward (Aliat Law); the Nomad City masterplan permitting and CONFOTUR mandate (Guzmán Ariza, September 2026).

  • Ayuntamiento de Samaná · Ministerio de Medio Ambiente

    Permitting · 2024–2026

    Construction permit issued 7 November 2024; environmental permit issued 22 July 2025; Certificado de Permiso de Obra issued 18 March 2026. MITUR land-use and CONFOTUR classification in progress.

À propos de cette chronologie. Chaque entrée est tirée des documents d’époque de l’entreprise elle-même — contrats notariés, permis, rapports du fiduciaire, lettres aux investisseurs et mises à jour de chantier communiquées aux acheteurs à la date indiquée.

À propos des images. Tout élément marqué Photo a été pris sur site à la date indiquée, à partir de relevés par drone et de mises à jour de chantier. L’unique image marquée Rendu est une visualisation de conception et est identifiée comme telle. Chaque film lié ici a été publié à la date indiquée et n’a pas été remonté depuis.

À propos des échéances à venir. Les objectifs restent des objectifs, et sur un site de montagne sous les tropiques, ils dépendent de l’enchaînement des permis, de la disponibilité des entrepreneurs et de la saison des pluies. Ils sont publiés malgré tout, et mis à jour ici à mesure qu’ils évoluent.

Samana Group · Péninsule de Samaná, République dominicaine · Chronologie mise à jour le 5 octobre 2026

Commencez votre aventure dès aujourd’hui.

Inscrivez-vous et recevez gratuitement notre e-book sur Nomad City ainsi que des contenus exclusifs sur l’investissement.

Téléphone (facultatif)
Investir dans Land Trust →

En vous inscrivant, vous acceptez notre politique de confidentialité. Nous ne faisons pas de spam.
